Systems and technology

Everything behind the units we deliver.

The five systems, how the composite panel is built up, how the joint seals without site-applied sealant, the four positions one block makes, and what changes when the concrete is cast in a factory instead of on the ground.

What we make

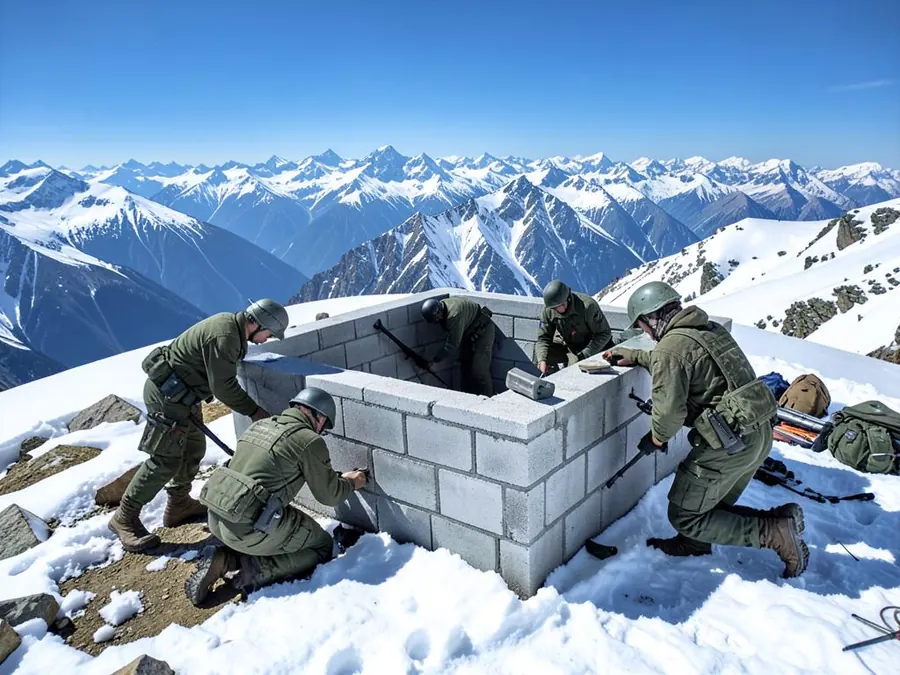

RUBIK PD

1. RUBIK PD

Patented interlocking bunker

150 blocks of 17 kg, dry-stacked into a rifle-resistant position in under seven hours. Developed with 52 Engineer Regiment, Corps of Engineers, and the Army Design Bureau.

Enquire →

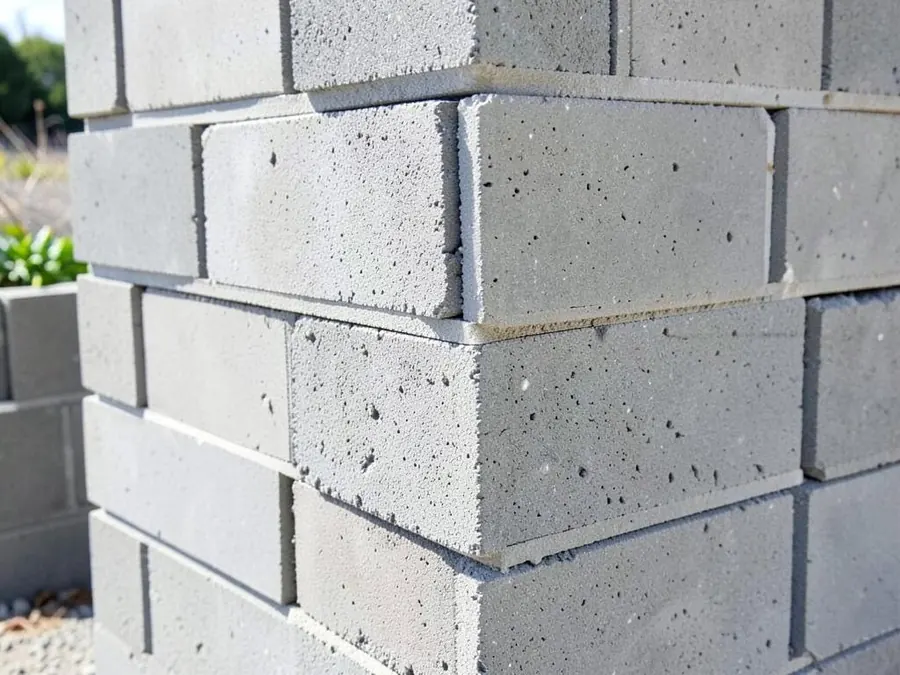

Interlocking composite blocks

2. Interlocking composite blocks

Dry-stack walling for high altitude

Half the weight of PCC, four times the lateral stability, and a capillary break that keeps seepage out of the joint. Nothing is mixed or poured at the position.

Enquire →

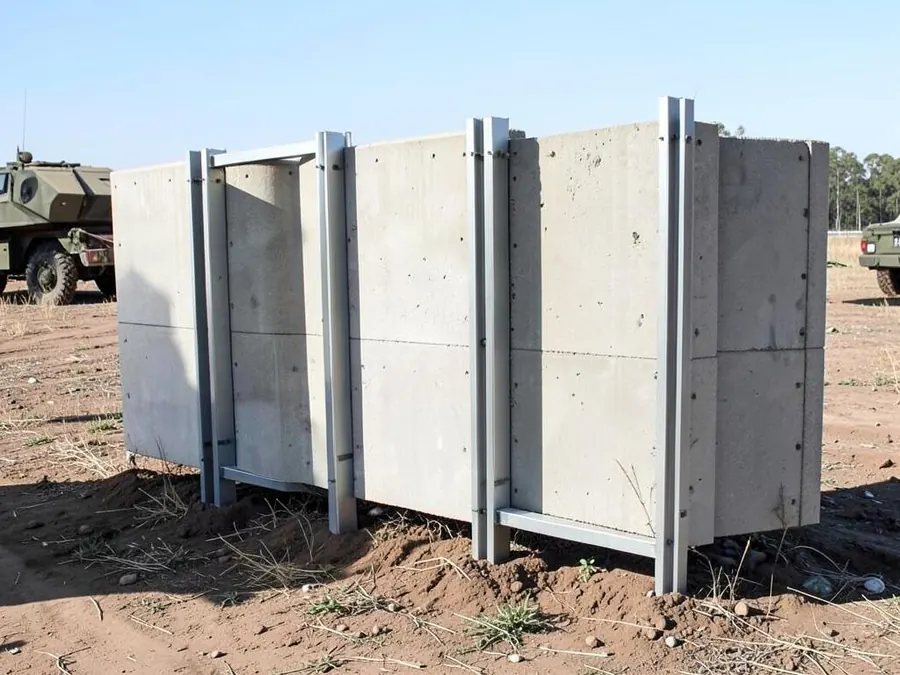

Modular ballistic plate system

3. Modular ballistic plate system

Breast walls and rapid posts

Ballistic concrete plates slide into light steel frames. Under 10 kg a plate, three personnel, operational in roughly four hours.

Enquire →

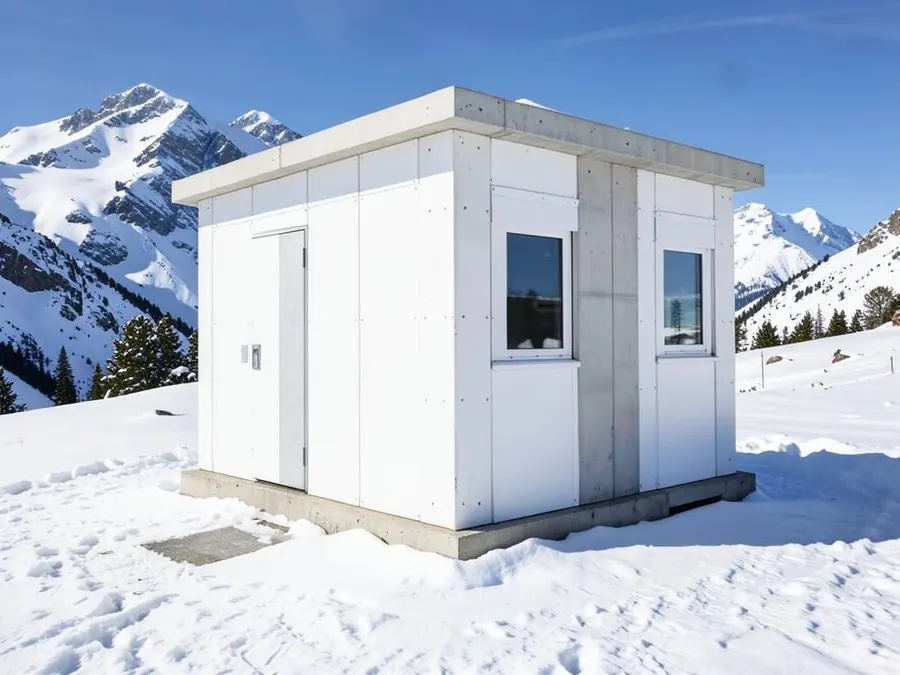

UHPC-EPS shelter

4. UHPC-EPS shelter

Insulated panel shelter for remote posts

Hard ultra-high-performance concrete skins over an insulating core, joined by a gasketed interlock instead of field-applied sealant.

Enquire →

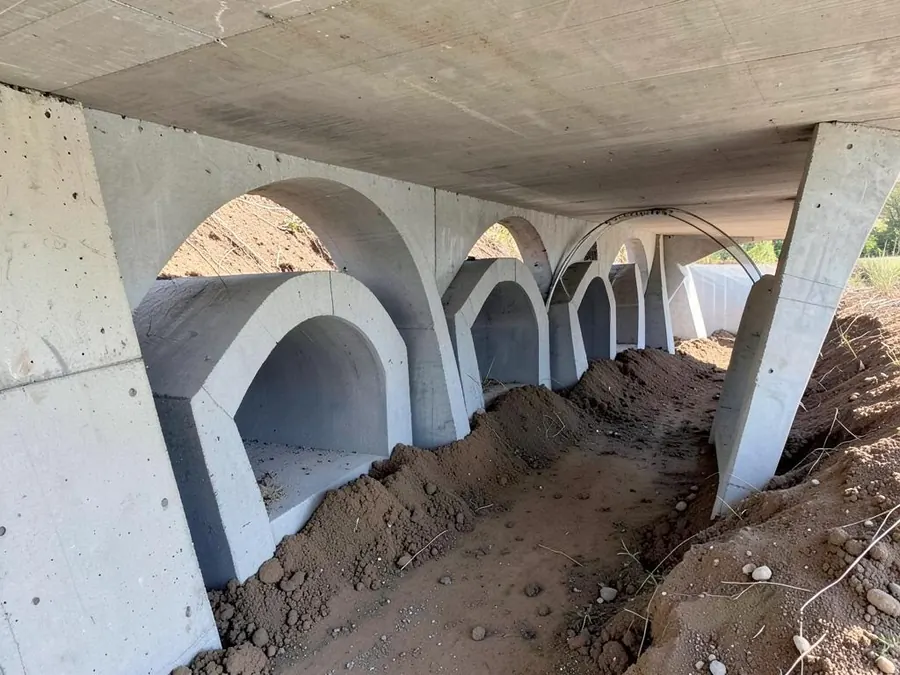

The Hive

5. The Hive

Modular precast communication trench

Interlocking walls and an arched roof, soil-filled for blast and soil pressure. Sections are replaced individually rather than cut out and recast.

Enquire →

Designed with the people who have to build it under fire.

RUBIK PD was developed in collaboration with 52 Engineer Regiment, Corps of Engineers, and the Army Design Bureau. The research reads the same lessons the Army is reading: Russia–Ukraine, subterranean warfare, and the rise of loitering munitions and kamikaze drones against static positions.

<10 kg
per ballistic plate, man-portable
4 hrs
to an operational position
70%
less logistics than building on site
10,000+ ft
rated, and below freezing

Build, test, mock up, then pilot.

Roughly twelve to twenty weeks from a frozen specification to a pilot on your ground. Performance figures are confirmed by testing at an approved laboratory for each project and its stated threat level.

  1. Weeks 1–2

    Design freeze

    Specification fixed against your threat level and siting.

  2. Weeks 3–6

    Prototype

    Panels built from the frozen drawing, under process control.

  3. Weeks 7–12

    Lab tests

    Airtightness, thermal, structural, durability, fire.

  4. Weeks 13–14

    Field mock-up

    Assembled on your ground by your own team.

  5. Weeks 15–20

    Pilot

    Limited roll-out with the data pack and training module.

Common questions

The questions that come up before a specification does.

Can a position be built below freezing?+

Yes, because nothing cures on site. Every unit is cast, cured and tested under factory control in Pan India and carried up finished. Assembly is dry, so there is no water, cement or aggregate at the position and no pour waiting on the weather.

How long does one position take to put up?+

A RUBIK PD position goes up in under seven hours with four soldiers: about thirty minutes to level the surface, two and a half hours to stack and lock the blocks, an hour and a half for the window, door and infill, and two and a half hours for the finish coat and overhead protection.

What does one person actually have to carry?+

A RUBIK PD block weighs 17 kg and a position uses about 150 of them. A ballistic plate is under 10 kg. Everything is sized as a man-portable load, because machinery stops well short of a post at 4,300 metres.

Can a damaged position be repaired in the field?+

Repair is sectional. The affected unit is swapped rather than cut out and recast, and RUBIK PD is repairable in place without losing strength or protection.

Can a position be moved once it is built?+

RUBIK PD is relocatable at no cost when siting considerations change, since the blocks are dry-stacked rather than bonded. Field of view and field of fire are adjusted by changing the block layout.

How is protection verified?+

By testing at an approved laboratory for each project and its stated threat level. The route from a frozen specification to a pilot on your ground runs roughly twelve to twenty weeks.

What do you need from us to quote?+

Altitude, access, threat level and the number of positions. That is enough to come back with a specification rather than a brochure. Trial reports and reference projects are released to identified buyers after an enquiry.

Enquiry

Tell us the project.

Drawings or a sketch, the quantity and where it has to be delivered. That is enough for us to come back with a specification and a rate.

Opens WhatsApp with your enquiry filled in
